Ctrl+K

Scopes & WBS

BOQ items are client requirements, but they may not correspond to the execution plan. For example, a BOQ for "excavation" might cover an entire project, but execution happens structure-by-structure. You must break BOQs into sub-items called Scopes, organized in a WBS (Work Breakdown Structure).

How to Approve Project Scopes 0:38
Scope and WBS management workflow showing standard and shortcut paths
Scope management workflow — standard path (WBS copy → customize → link to BOQ) vs shortcut path (auto-create scopes from BOQ).

WBS Hierarchy

The Work Breakdown Structure follows a four-level hierarchy from broadest to most specific:

LevelNameDescription
1 Package Top-level grouping of related work (e.g., "Civil Works", "MEP")
2 Parent Scope Group Major category within a package (e.g., "Structural", "Finishing")
3 Scope Group Specific grouping of related activities (e.g., "Concrete Work")
4 Scope Individual execution activity (e.g., "M25 Grade Concrete")

Scope Master Fields

Each scope item in the WBS template is stored in omni_scope_master (10 columns):

FieldDB ColumnTypeDescription
Code scope_code varchar(50) Unique scope identifier within the template
Description scope_description varchar(max) Full description of the execution activity
Scope Group scope_group_id int (FK) Parent group in the WBS hierarchy
UOM uom_id int (FK) Default unit of measure for this scope
Rate rate money Default rate (can be overridden per job)
CPV Code CPVCode varchar(30) Common Procurement Vocabulary code (EU classification)

Job Scope Fields

When scopes are copied to a job, they become Job Scopes stored in omni_job_scope (23 columns) with job-specific data:

How to Create Job Scopes (WBS) 0:37
FieldDB ColumnTypeDescription
Code job_scope_code varchar(max) Scope code within this job
Description job_scope_description varchar(max) Job-specific description (can differ from template)
Quantity quantity money Planned quantity for this job
UOM uom_id int (FK) Unit of measure (inherited or overridden)
Rate rate money Rate for this scope in this job
Value value money Calculated: quantity × rate
Planned Start planned_start datetime Scheduled start date
Planned Finish planned_finish datetime Scheduled completion date
Actual Start actual_start datetime When work actually began
Actual Finish actual_finish datetime When work was actually completed
As-built Qty actual_final_asbuilt_qty float Final measured quantity after execution
BOQ Link boq_id int (FK) Linked BOQ item (set when linking scopes to BOQ)
IDC IDC_id int (FK) Indirect Cost category assignment

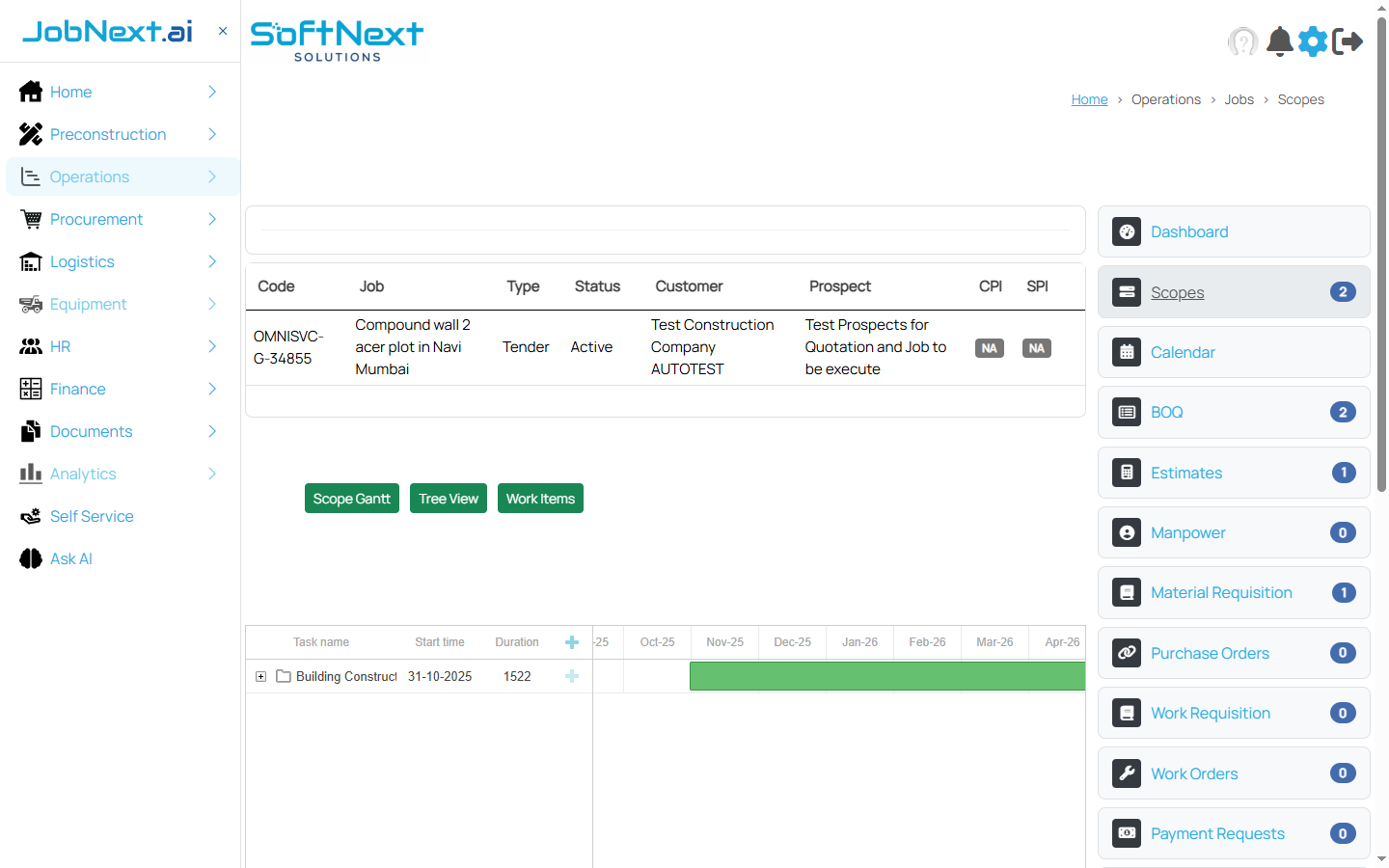

Scopes tab showing Gantt chart view with scope timeline bars
Scopes tab — Gantt chart view showing scope timelines, with toggle buttons for Scope Gantt, Tree View, and Work Items.

WBS Template Library

JobNext provides a library of pre-existing WBS items (the WBS Template) that can be copied into a Job as execution scopes. This template contains standardized activities that organizations use across projects. The template is a shared organizational asset — additions should be carefully considered.

How to Copy Scopes from WBS

  1. Navigate to the Job and open it
  2. Click Scopes in the horizontal menu tabs
  3. Click Copy from WBS button
  4. Browse the WBS template tree — expand Packages, Parent Scope Groups, and Scope Groups
  5. Check the boxes next to the scope items you need for this job
  6. Click Copy Selected to import them as Job Scopes
  7. After copying, set the quantity, rate, planned dates, and notes for each scope

Important Rules

Rule 1 — New WBS Items are Rare: Creating a new WBS Item (Packages, Parent Scope Groups, Scope Groups, or Scopes) should be a rare event. Only create new items if a particular Job requires an Activity Type that does not exist in the template. The WBS template should be treated as a shared organizational asset.
Rule 2 — One-Time Copy: Copying scopes from WBS can be done once when the Job is freshly created. Once new Scopes have been added to the Job, the Copy function is disabled. Plan your scope selection carefully before executing the copy.

Linking Scopes to BOQs

After scopes are copied, they must be linked to BOQ items to establish the cost and schedule relationship:

  • BOQ Items are client deliverables
  • Scopes are execution items
  • To deliver a BOQ Item, one or more Scopes need to be executed
  • Linking establishes which scopes contribute to which BOQ deliverables

Linking Parameters

ParameterDescription
BOQ Conversion Factor Converts scope quantity to the equivalent BOQ quantity
Stage % Percentage of the BOQ rate applied to each stage (for stage-wise BOQs)
Linking rules: Multiple Scopes can be linked to a single BOQ. However, a Scope that is already linked to one BOQ cannot be linked to another BOQ. For stage-wise BOQs, link the Scope to the Stage of the BOQ, not the BOQ directly.
Alternative: If client BOQs are detailed enough for execution planning, consider using BOQ to Scope Conversion to skip separate scope creation and linking entirely.
